Shamrock Log Home Construction Day 15 - 33
Day 15
September 22nd, Wednesday

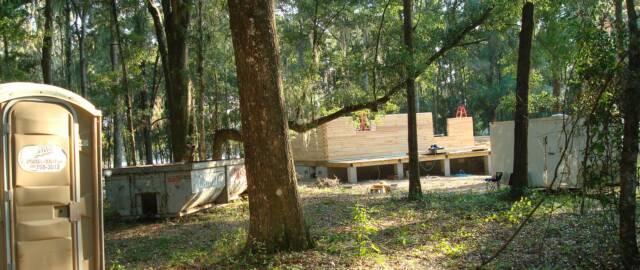

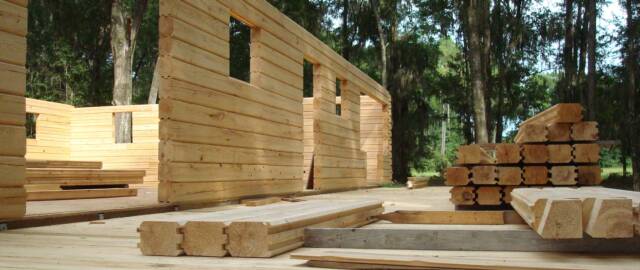

Day 15 – Crew making good progress, stacking logs. Trash Dumpster delivered and job site cleaned.
Day 16
September 23rd, Thursday

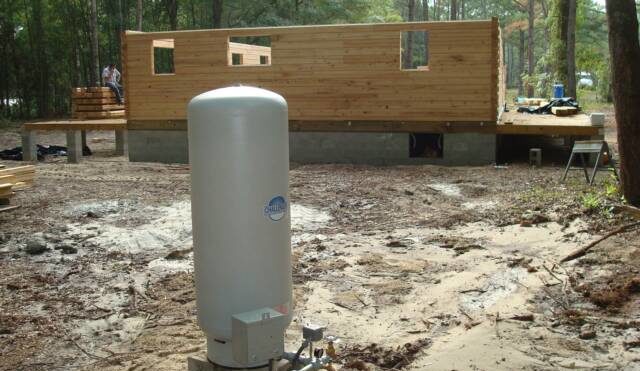

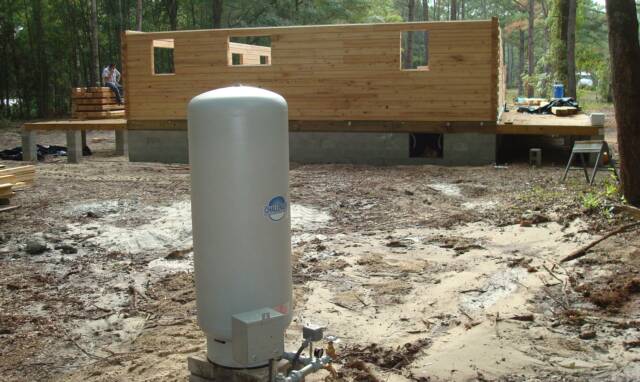

Day 16 – Crew close to having log wall stack complete. Well contractor onsite, drilled approximately 170 feet deep and installed 1.5 hp pump with the tank.
Day 17
September 24th, Friday
Day 17 – Crew continues log wall stack, installs decking on 12ft back covered porch. Built temporary stairs. Received interior framing package. Electric company onsite set transformer and energized temporary electric pole.
Day 18
September 25th, Saturday

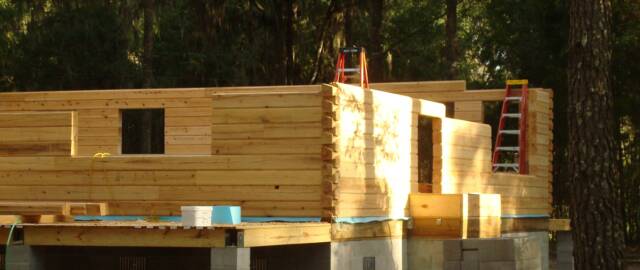

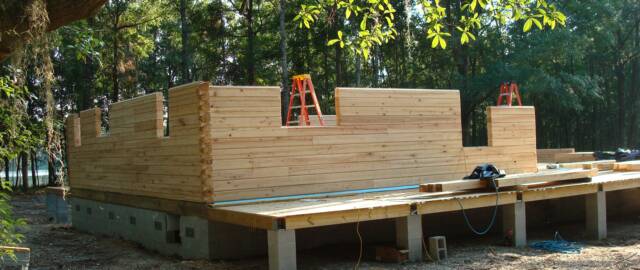

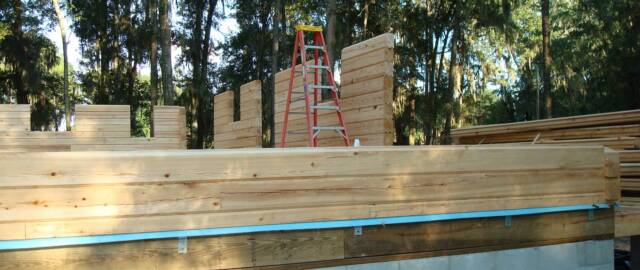

Day 18 – Crew continues working on log stack.
Day 19-21
September 26th, Sunday
Day 19 – No Work
September 27th, Monday
Day 20 – Rained out.
September 28th, Tuesday

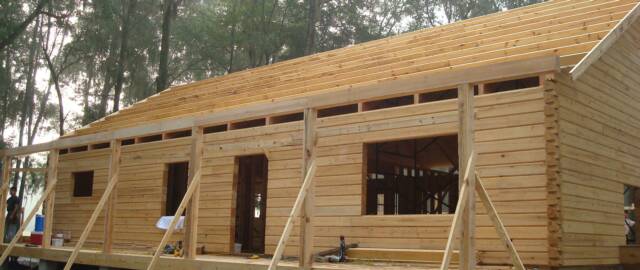

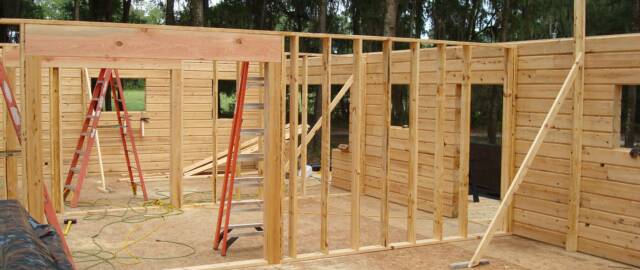

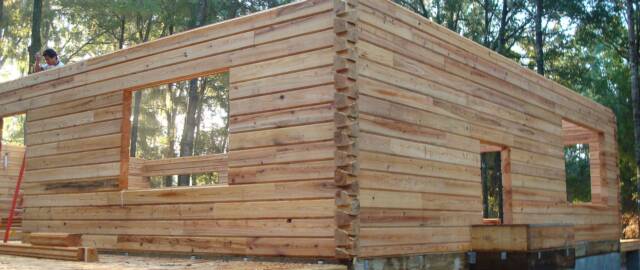

Day 21 – Log walls complete, Interior Framing 50%.
Day 22-23
September 29th, Wednesday

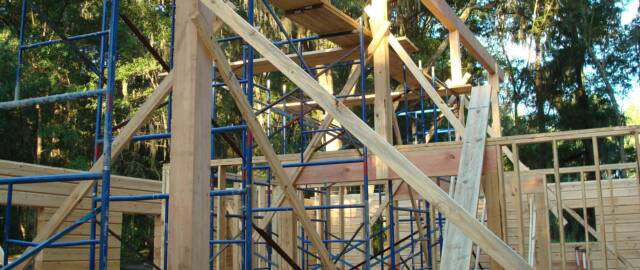

Day 22 – Worked 1/2 day due to rain. Crew continues working on framing and starts roof support post.
September 30th, Thursday

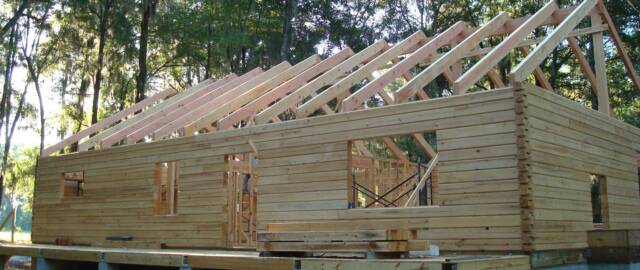

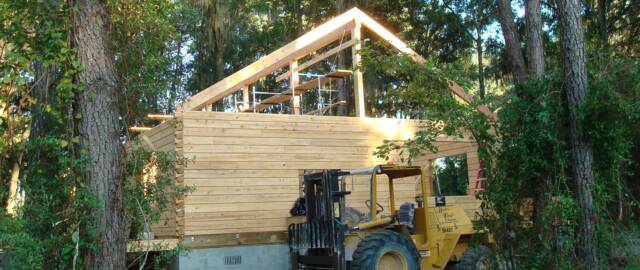

Day 23 – Crew works on Structural Open Beam Roof System
Day 24-25
October 1st, Friday
Day 24 – Crew working on open beam roof system.
October 2nd, Saturday

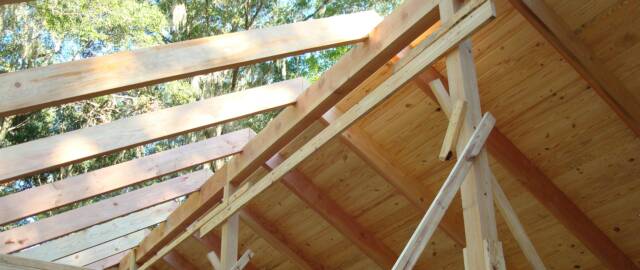

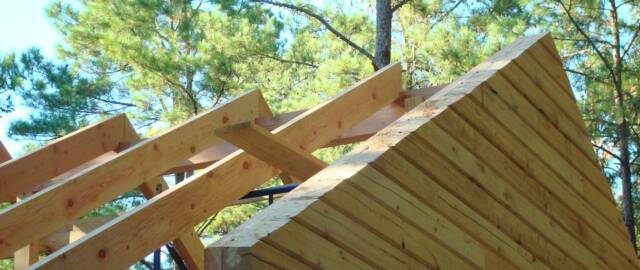

Day 25 – Crew installed all rafters on Structural Open Beam Roof System
Day 26-28
October 3rd, Sunday
Day 26 – No work.
October 4th, Monday
Day 27 – Crew working on full log gables ends.
October 5th, Tuesday
Day 28 – Crew finished full log gables.
Day 29
October 6th, Wednesday
Day 29 – Crew begins installing T&G roof covering. Electrician onsite coordinating wiring drops for ceiling areas and scheduled to be onsite to install on Monday.
Day 30
October 7th, Thursday

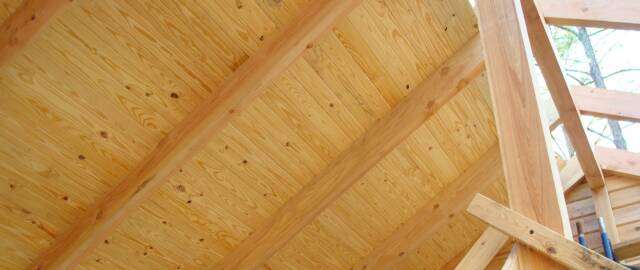

Day 30 – Crew finishes installing T&G roof covering.
Day 31
October 8th, Friday
Day 31 – Crew working on installing open beam roof purlin system.
Day 32-33
October 9th, Saturday
Day 32 – Crew finishing open beam roof purlin system and working on open beam covered porches.
October 10th, Sunday – Day 33 – No work.
